Commercial Move Checklist 2026: Plan Your Office Relocation
A commercial move checklist is a phased task plan that covers every critical action from 12 months before your move through 90 days after occupancy. Business owners relocate for growth, cost reduction, better locations, or to support hybrid work models. Each of these reasons demands a different set of priorities, but all share the same risk: missing a deadline in one phase creates a cascade of problems in the next. This office moving checklist 2026 addresses IT infrastructure, lease obligations, vendor coordination, and employee communication so you can execute a clean, cost-controlled relocation.
What does a commercial move checklist 2026 cover?
A well-built office relocation checklist 2026 spans six distinct phases. Commercial moves typically require a 6–18 month timeline from planning through occupancy, depending on office size and market conditions. That range is not a suggestion. Large offices that start planning fewer than 12 months out routinely miss lease notice deadlines and face construction delays that push move-in dates back by months.

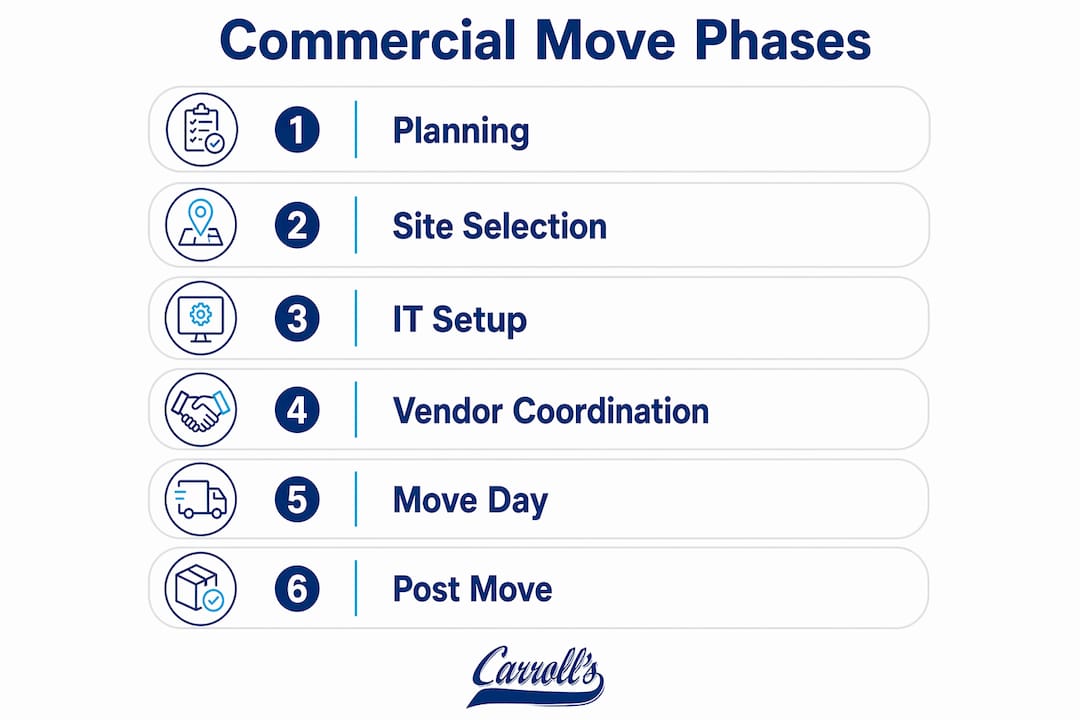

The six phases are: planning and project setup, site selection and lease negotiation, IT and operational setup, vendor and logistics coordination, move week execution, and post-move stabilization. Each phase has its own set of owners, deliverables, and deadlines. Skipping a phase or treating it as optional is where most business relocations go wrong.

How to start your commercial move planning
The first task in any business relocation guide 2026 is assigning a dedicated project owner. Failure to assign ownership across seven or more project phases is the most frequent cause of delays in commercial moves. One person must hold overall accountability, with cross-department coordinators covering IT, finance, HR, and executive sponsorship.
Once ownership is set, define your move objectives clearly. Are you reducing square footage, adding collaboration space, or moving closer to a transit hub? The answer shapes every decision that follows, from lease terms to furniture layout.
Key planning tasks to complete first:
- Set a realistic move date based on your current lease expiration and required notice period
- Establish a budget with a 15–20% contingency for inflation and unexpected costs
- Review your current lease for decommissioning and restoration clauses before signing anything new
- Identify cross-department coordinators and schedule weekly check-ins from day one
- Build a master project timeline in a shared tool that all coordinators can update in real time
Pro Tip: Read the role of a commercial move manager before you assign your project owner. The scope of the role surprises most managers who have not run a commercial relocation before.
Budget planning deserves special attention. Decommissioning clauses requiring restoration of old office spaces can cost 3 to 5 times more than the physical move itself. That single line item has derailed otherwise well-planned relocations. Get a restoration cost estimate from a contractor before you finalize your total move budget.

How do you select and secure the right new commercial space?
Site selection starts with a detailed needs assessment. Calculate your required square footage based on headcount, desk-sharing ratios, and meeting room demand. Factor in storage, server rooms, and any specialized spaces your operation requires.
Understand local market vacancy rates before you commit to a timeline. In tight markets, quality spaces lease quickly, and you may need to sign a lease before your current one expires. Negotiate lease terms that include favorable restoration obligations. Restoration language in commercial leases often requires returning a space to a shell state, a cost that can exceed the physical moving costs by a wide margin.
| Lease negotiation priority | Why it matters |
|---|---|
| Restoration obligations | Undefined scope leads to disputes and unexpected costs at exit |
| Fit-out allowance | Landlord contributions reduce your upfront capital outlay |
| Lease commencement flexibility | Allows buffer time for construction overruns |
| Break clauses | Protects you if business conditions change mid-lease |
Plan fit-out and customizations early. Construction lead times range from 2 to 9 months depending on scope and contractor availability. If you need custom partitions, server room cooling, or accessibility upgrades, those orders must go in well before move day. Flexible workspace options such as coworking memberships or short-term subleases can bridge the gap if your new space is not ready on schedule.
Pro Tip: Review the office relocation planning checklist from Atlantic Star Group for a detailed breakdown of lease negotiation phases and fit-out timelines.
What does IT setup look like for a zero-downtime move?
IT coordination is the phase most businesses underestimate, and it is the one most likely to cause move-day disruptions. Internet provisioning delays are the leading cause of move-day downtime. On-net buildings require 30–60 days for circuit provisioning. Off-net buildings can take 90–120 days. Order your internet circuits the same day you sign the new lease.
Here is the correct sequence for IT setup:
- Order internet circuits on lease signing day, specifying bandwidth requirements and redundancy needs
- Conduct a Wi-Fi site survey at the new space to identify dead zones and access point placement
- Complete a full IT asset inventory, tagging every device, cable, and peripheral with its destination location
- Label all hardware and cabling using a color-coded system that matches your floor plan
- Configure and test hybrid workspace software including desk booking, room scheduling, and visitor management at least two weeks before move-in
- Schedule a full technology dry run at the new site before move day to catch configuration errors
The dry run is the step most IT teams skip because it feels redundant. It is not. A dry run surfaces problems with VoIP systems, access control integrations, and network segmentation that only appear when all systems run simultaneously.
Pro Tip: Assign a dedicated IT coordinator who attends every vendor meeting and signs off on every infrastructure milestone. Do not let IT tasks default to the general project owner.
| IT task | Timeline before move day |
|---|---|
| Order internet circuits | Day of lease signing |
| Wi-Fi survey | 10–12 weeks out |
| Asset inventory and labeling | 6–8 weeks out |
| Software configuration | 4–6 weeks out |
| Technology dry run | 1–2 weeks out |
How do you coordinate vendors, packing, and employee communication?
Vendor coordination starts with your commercial mover. Licensed commercial movers with certificates of insurance are required to access most Class A office buildings. Confirm your mover’s credentials before signing a contract. Book freight elevator slots and building access windows months in advance, especially in urban buildings where elevator time is shared.
Move week logistics checklist:
- Confirm mover credentials, insurance certificates, and contract terms at least 60 days before move day
- Reserve freight elevators and loading dock access at both the old and new buildings
- Implement a color-coded packing system where each department uses a distinct color label tied to its destination zone
- Prepare an essentials box for each team containing items needed on day one: chargers, login credentials, basic office supplies
- Assign on-site coordinators at both locations to direct movers and resolve issues in real time
- Document the condition of the old premises with timestamped photos before movers begin
Employee communication is not a soft skill task. Clear, frequent communication reduces anxiety and rumors, improving morale and cooperation during moves. Issue a move FAQ document at least eight weeks before move day. Send weekly updates as the date approaches. Tell employees what is changing, what is staying the same, and what they need to do personally. Silence creates speculation, and speculation creates resistance.
Check out questions to ask moving companies before you finalize your vendor selection. The right questions reveal whether a mover has genuine commercial experience or primarily handles residential jobs.
What should you do in the first 90 days after moving in?
Post-move stabilization is a defined phase, not an afterthought. The first week focuses on IT troubleshooting and system adjustments. Expect issues with VoIP call quality, printer network assignments, and access control permissions. Have your IT coordinator on-site for the first three days.
Update your business address across all public and legal records within the first two weeks. This includes your website, Google Business Profile, state business registration, bank accounts, insurance policies, and client contracts. Missed address updates create compliance gaps and confuse clients.
Occupancy sensor data and booking platform analytics help identify over-utilized and under-utilized spaces within 60–90 days of move-in. Use that data to adjust desk layouts, refine booking rules, and update hybrid scheduling policies. A space that looked right on paper often performs differently once employees actually use it.
Pro Tip: Run a structured employee feedback survey at the 30-day and 90-day marks. Ask specific questions about commute impact, workspace comfort, and technology reliability. The answers tell you exactly where to focus your optimization effort.
Key Takeaways
A successful commercial relocation requires phased planning, dedicated project ownership, and early IT action to prevent downtime and budget overruns.
| Point | Details |
|---|---|
| Start 12–18 months out | Large office moves require long lead times for leases, fit-outs, and IT provisioning. |
| Assign a project owner first | One accountable leader with cross-department coordinators prevents missed deadlines. |
| Order internet on lease day | ISP provisioning takes 30–120 days; delays are the top cause of move-day downtime. |
| Budget for restoration costs | Decommissioning old space can cost 3 to 5 times the physical move expense. |
| Optimize after 60–90 days | Use occupancy data to adjust layouts and hybrid policies based on actual usage. |
What I have learned from watching commercial moves go sideways
The most common mistake I see is treating a commercial relocation as a logistics problem rather than an operational transition. Businesses focus on boxes and trucks while the real complexity sits in lease obligations, IT dependencies, and employee behavior change. By the time the physical move happens, the decisions that determine success or failure have already been made.
The second pattern I notice is underestimating the project owner role. Most managers assign the move to someone who already has a full workload. That person then manages the move reactively, responding to problems instead of preventing them. A commercial move at any meaningful scale needs someone whose primary job for the duration is the move itself.
The third issue is IT, specifically internet provisioning. I have seen well-organized moves grind to a halt because the new office had no working internet on day one. The team knew about the 90-day provisioning window. They just did not believe it applied to them. It always applies. Order the circuits the day you sign the lease, without exception.
The types of office relocation services available in 2026 give businesses more options than ever for managing each phase professionally. Use them. The cost of professional support is almost always lower than the cost of a delayed or disrupted move.
— Michael
Carrollsmv is ready to support your 2026 commercial move
Planning a commercial relocation on Cape Cod or Martha’s Vineyard? Carrollsmv brings over 95 years of family-owned moving experience to every business relocation, with licensed crews, specialized equipment, and the scheduling flexibility your operation needs.
Carrollsmv’s commercial moving services cover everything from office furniture transport to full-service coordination, with white glove handling for sensitive equipment and high-value assets. Need a place to store furniture or equipment during your transition? Carrollsmv’s secure self-storage options keep your assets safe between move phases. Contact Carrollsmv today for a personalized moving plan built around your timeline and budget.
FAQ
How far in advance should I start planning a commercial move?
Commercial moves require 6–18 months of planning depending on office size. Large offices should begin 12 months out to align lease notices, fit-out construction, and IT provisioning.
What is the biggest cause of delays in office relocations?
Failure to assign ownership across all project phases is the most frequent cause of delays. Appointing a dedicated project owner with cross-department coordinators prevents this.
When should I order internet service for my new office?
Order internet circuits the day you sign your new lease. On-net buildings take 30–60 days to provision; off-net buildings can take up to 120 days.
How much should I budget for decommissioning my old office?
Budget separately for restoration costs. Decommissioning clauses can require returning a space to shell condition, costing 3 to 5 times the physical move expense.
How do I know if my new office layout is working after the move?
Use occupancy sensors and desk booking data to measure actual space usage. Adjusting layouts within 60–90 days of move-in improves productivity and employee satisfaction based on real usage patterns.
